5 Steps to Apply for Zoning Amendments in Toronto
Commercial Real EstateMay 10, 2026 11 min read

5 Steps to Apply for Zoning Amendments in Toronto

5 Steps to Apply for Zoning Amendments in Toronto

If you're planning a project in Toronto that doesn't align with current zoning rules - like changing land use, increasing building height, or modifying setbacks - you'll likely need a zoning amendment. Here's a quick breakdown of the process:

  1. Identify the Amendment Type: Determine if your project requires a Zoning By-law Amendment (ZBA) for specific property changes or an Official Plan Amendment (OPA) for broader land-use modifications.
  2. Prepare Required Documents: Gather site plans, a Planning Rationale Report, ownership documents, and any necessary assessments (e.g., traffic or environmental studies).
  3. Submit Your Application: Use Toronto’s digital submission platform, ensuring all documents meet the City's checklist.
  4. Participate in Public Consultation: Engage with community feedback during the statutory public meeting to address concerns and support your proposal.
  5. Complete the Approval Process: Await City Council’s decision, navigate the appeal period, and meet any additional requirements like site plan approval or building permits.

Deadlines are strict: ZBAs must be resolved in 90 days, while OPAs allow 120 days before an appeal can be filed. Missing a step or deadline could delay your project. Consulting a planning professional is often helpful to navigate this process efficiently.

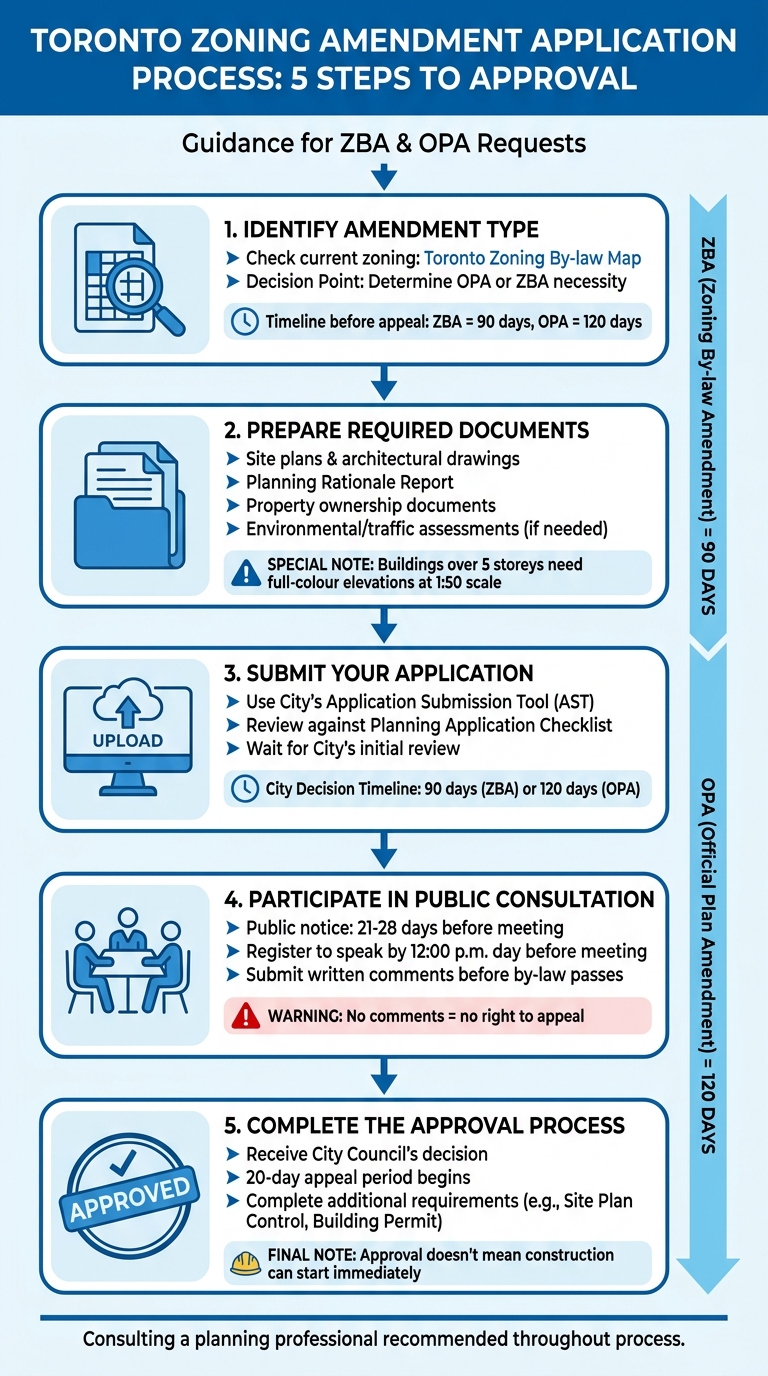

5-Step Process for Applying for Zoning Amendments in Toronto

5-Step Process for Applying for Zoning Amendments in Toronto

Step 1: Identify the Required Amendment Type

Check Your Property's Current Zoning

Start by confirming your property's zoning designation. Toronto's Zoning By-law Map is a helpful tool for this. You can search for property-specific details using a street address, postal code, intersection, or even a place name. Once you enter your information, the map will show a list of possible matches. Select your property, and the map will zoom in, marking the location with a red dot and address label. For partial street names (like typing "arm" for Armadale Avenue) or hyphenated addresses (e.g., entering "3027" for 3027-3029), this tool works effectively to generate accurate results.

If the map doesn’t locate your property, you can call 311 if you're in Toronto or 416‑392‑2489 if you're outside the city. TTY services (via 711) and multilingual support are also available through 311.

Once you've identified your property's zoning, the next step is determining which type of amendment your project requires.

Determine if You Need an OPA or ZBA

After confirming your zoning, compare it against your project’s requirements. If your project involves changing the land use - like adding retail or residential spaces - then you'll need an Official Plan Amendment (OPA). On the other hand, if your project requires adjustments to existing property rules, such as increasing building height or modifying setbacks, a Zoning By-law Amendment (ZBA) is necessary.

Getting the amendment type right is essential for keeping your project on schedule. ZBAs must be resolved within 90 days, while OPAs allow 120 days before an appeal can be made. If you're unsure which amendment applies, consulting a planning professional can save time and prevent costly mistakes. Additionally, Toronto’s 311 service can guide you through application requirements and the next steps.

Creative Intensification Build - Zoning Bylaws - Replacing a Single Family Home With Ten Units

Video thumbnail

Step 2: Prepare Your Application Documents

After identifying the type of amendment you need, the next step is gathering all the necessary documents. Your application must clearly show how your project aligns with Toronto's Official Plan and justify why the amendment is required. Each document serves a specific purpose in the City's review process. Start with your site plans, move on to a detailed planning report, and include any other required supporting materials.

Site Plans and Architectural Drawings

Your site plans should provide detailed information about the layout of your project. This includes building locations, landscaping, waste and recycling points, access routes, and key design features. For buildings taller than five storeys, you'll need to include full-colour elevations drawn to a 1:50 scale. These must cover at least three typical bays for the first three storeys and highlight the main entrance.

Make sure to label all exterior design elements, including materials and window types (e.g., vision glass versus spandrel). For the first 16 metres of the building, you need to show window patterns and treatments that meet the Toronto Green Standard. If your project involves a new building larger than 1,000 square metres, your drawings should also include a designated area for signage acknowledging the Architect of Record or Design Architect, with a minimum size of 0.06 square metres.

Before finalising your site plans, check if your property lies within hospital helicopter zones or airport flight paths. If it does, you’ll need to submit an Aeronautical Report to justify your proposed building height. Additionally, use the "TO maps" database to determine if your property has archaeological potential and consult an arborist to identify regulated trees within six metres of your property lines.

Planning Rationale Report

This document is a professional analysis that explains your proposal and provides a rationale for the requested amendment. Your Planning Rationale Report should demonstrate consistency with the Provincial Policy Statement and the Growth Plan for the Greater Golden Horseshoe. It must also show how your proposal aligns with the City of Toronto Official Plan, addressing land use designations, built form policies, and public realm standards.

The report should evaluate your proposal against the zoning ordinance's "approval criteria" to address any potential weaknesses. You’ll need to show that your project is compatible with nearby land uses and won’t negatively affect existing developments or property values. If your proposal conflicts with the Official Plan - such as switching from low-density to high-density residential - you’ll need to apply for an Official Plan Amendment at the same time.

Other Required Documents

In addition to site plans and the Planning Rationale Report, you’ll need to gather property ownership documents, legal descriptions, and possibly environmental assessments or traffic studies. These documents help confirm that your proposed amendment won’t cause significant traffic issues or overburden existing public infrastructure.

You may also need to provide evidence supporting the "need" for the zone change. This often involves demonstrating that conditions have changed significantly since the original zoning or that an error was made during the initial zoning process.

Step 3: File Your Application with the City

To move forward, submit your complete application to the City of Toronto through their digital platform. Be sure to follow the city's submission guidelines carefully. Double-check that your application package is complete before uploading it - missing documents could slow things down. Once submitted, the City will conduct an initial review to ensure everything is in order. Cross-reference your application with the checklist provided during your Pre-Application Consultation to avoid any issues.

Review Your Application for Completeness

Your application must include all the items listed in your Planning Application Checklist. This checklist, given to you after the mandatory Pre-Application Consultation (PAC), outlines exactly what the City expects. Essential components include a detailed explanation of your zoning amendment request, property sketches, site plans, and a Planning Rationale Report that demonstrates how your proposal aligns with the City's Official Plan.

Don't forget to include information for all properties impacted by the proposed changes - not just your own. Gregory Woodward, Associate at Lerners LLP, provides valuable insight:

"The application will generally need to set out the reasons for the request, sketches, plans, and information regarding the property or properties affected".

If you’re unsure whether your application is complete, it’s worth consulting a lawyer or planning consultant who specializes in land use.

Use the City's Submission Portal

The City of Toronto requires all zoning amendment applications to be submitted through the Application Submission Tool (AST). This centralized digital portal is designed for development applications. Upload your site plans, architectural drawings, Planning Rationale Report, and all other supporting documents. Make sure every file is clearly labelled and organized according to the City's guidelines. Once your application is submitted, you can monitor its progress as it goes through the review process.

Wait for the City's Initial Review

After submission, city planning staff and relevant agencies will review your application. They’ll notify neighbours who may be affected, invite feedback, and prepare a recommendation to approve, deny, or defer your application. If the City doesn’t reach a decision within 90 days (or 120 days for an Official Plan Amendment), you have the option to appeal to the Ontario Land Tribunal. However, many developers prefer to wait for the City’s decision and make any requested changes instead of appealing, especially when a favourable outcome seems achievable.

Step 4: Attend the Public Consultation

After the City completes its initial review, the next step is the public consultation. This stage is critical before moving on to final approvals in Step 5. At this point, your application reaches the statutory public meeting phase, where community members and stakeholders can share their thoughts on your proposed amendment. The Planning Act mandates that the City notify the public well in advance - usually 21 to 28 days before the meeting takes place. This allows neighbours and other interested parties time to review your proposal and prepare their feedback.

Your involvement in this process is essential if you want to safeguard your interests. If you fail to provide oral or written comments before the by-law is passed, you lose your right to appeal. As John D. Elvidge, City Clerk, explains:

"If a specified person or public body... does not make oral submissions at a public meeting or make written submissions to the City of Toronto before the proposed Zoning By-law Amendment is passed, the specified person or public body... is not entitled to appeal the by-law."

Public Meeting Notice Requirements

The City provides a public notice that includes details about the meeting, a summary of the proposal, the property location, and contact information for planning staff. This notice is published on the City’s website and is often live-streamed on the Toronto City Council Live YouTube channel.

If you wish to speak at the meeting, you’ll need to register with the Committee Administrator by 12:00 p.m. on the business day before the meeting. Written submissions can be sent via email or mail at any time before City Council makes its final decision. However, submitting them before the public meeting ensures they are part of the initial review. Keep in mind that all communications, including your name and contact details, become part of the public record unless you specifically request otherwise.

Present to Community Council

When presenting to the Community Council, prepare concise materials that clearly show how your proposal aligns with the City's Official Plan. The Planning and Housing Committee may require you to submit a written outline of your presentation to the Clerk before the meeting. Meetings are held in a hybrid format, allowing participation in person, via video conference, or by telephone. It’s a good idea to have your project experts available to address questions from both the committee and the public.

Public consultations often result in extensive feedback, which highlights the importance of active engagement. If you require any special assistance, such as TTY services, reach out to City staff ahead of time to make the necessary arrangements. Once this session is complete, your proposal will proceed to the final approval stage.

Step 5: Complete the Approval Process

After the public consultation phase, the City Council evaluates the Community Council's report and makes a decision. This could result in approval (with or without conditions), denial, or deferral of your amendment request.

Receive City Council's Decision

Once the City Council reaches a decision, you’ll receive official documentation detailing the outcome. If your amendment is approved, carefully review the decision notice. It may outline conditions like site plan agreements, associated fees, or specific coordination requirements.

Understand the Appeal Period

A mandatory 20-day appeal period begins as soon as the decision is issued. During this time, you - or any affected party - can file an appeal with the Ontario Land Tribunal (OLT) if there’s disagreement with the decision. Gregory Woodward, Associate at Lerners LLP, explains:

"If the application is approved and no appeals are submitted, the request in the application is put into place".

If no appeals are lodged within this window, the zoning amendment officially takes effect. Once the appeal period concludes without challenges, you can move forward with meeting any additional requirements before starting construction.

Complete Additional Requirements

Securing a zoning amendment is just one step - you’re not authorized to start construction yet. You’ll also need to obtain Site Plan Control approval, which focuses on design details like landscaping, built form, and site access. Additionally, you must apply for a building permit through the Toronto Building Division to ensure your project aligns with the Ontario Building Code.

To make this process smoother, consider using the City's Application Submission Tool. It can help simplify your permit applications and keep things on track.

Conclusion

This guide has walked you through the key steps - from preparing documentation to engaging in public consultations - needed to secure a zoning amendment in Toronto. The process requires careful planning and attention to detail. Whether you're applying for an Official Plan Amendment or a Zoning By-law Amendment, it's important to have all your paperwork in order, meet submission requirements, and actively participate in the public consultation and approval stages.

Deadlines and participation are non-negotiable. Missing a deadline or failing to submit comments during public meetings could mean losing your right to appeal to the Ontario Land Tribunal. Staying on top of these requirements is essential to keep your application on track.

Industrial projects face additional scrutiny. Employment Lands in Toronto, especially Core Employment Areas - which make up 75% of the city's employment lands - are tightly controlled and mostly designated for manufacturing and warehousing.

Seeking professional advice can make all the difference. Land-use planning consultants and commercial real estate lawyers can help you interpret Toronto's complex zoning rules, navigate the diverse requirements of its former municipalities, and ensure your application meets all standards. They can also safeguard your rights to appeal and might suggest a minor variance as a quicker alternative to a full amendment.

FAQs

Do I need an OPA, a ZBA, or both?

Whether you need an Official Plan Amendment (OPA), a Zoning By-law Amendment (ZBA), or both will depend on the details of your project. An OPA is used to modify overarching policies or land use designations outlined in the Official Plan. On the other hand, a ZBA focuses on adjusting specific zoning regulations, such as building setbacks or height restrictions. If your project involves major changes to land use, you might need both amendments. It’s always a good idea to consult a professional for advice tailored to your specific situation.

What studies might the City require for an industrial project?

The City of Toronto often asks for reports on land use, economic impact, and planning policy compliance when submitting zoning amendment applications for industrial projects. These reports are closely linked to how employment lands are treated and designated under city policies, including Official Plan Amendments for Employment Areas. Additionally, comprehensive planning and land use studies might be required as part of the zoning application process.

Can I start construction right after approval?

Before you can begin construction, securing a zoning amendment or minor variance approval isn’t the final step. You need to wait for the appeal periods to run out and ensure every condition tied to the approval has been satisfied. For minor variances, this usually involves a 20-day appeal period. Make sure all legal and procedural steps are completed before breaking ground.
